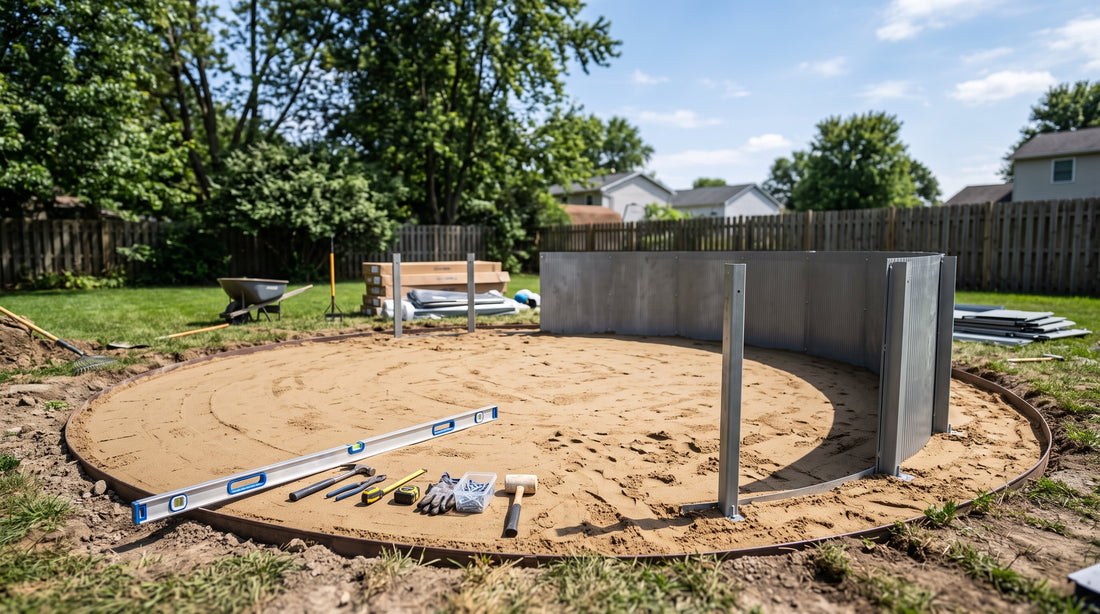

A partially installed above-ground pool wall on a leveled base

How to Install an Above-Ground Pool: A Step-by-Step Guide

Installing an above-ground pool is a genuinely doable weekend project for a handy homeowner with a couple of helpers and some patience. It is also, just as often, a job owners hand to a professional installer, especially for larger ovals or yards that fight back. Either path can produce a pool that lasts for decades, or one that wrinkles, leans, or fails early, and the difference almost never comes down to the assembly itself. It comes down to what is underneath it.

Quick answer: Installing an above-ground pool means picking a flat, code-compliant site; removing the sod; leveling the ground until the whole pad is within about an inch, end to end; laying a base; building the bottom track and wall; setting the uprights and top rails; installing the liner; and then filling in stages while smoothing wrinkles and connecting the pump and filter. Leveling is the step that decides whether the pool lasts, so it deserves more care than every other step combined.

Before you start: site selection, permits & tools

Where you put the pool matters as much as how you build it. Choose the flattest, best-drained spot the yard offers — low areas that collect runoff make it harder to keep a base level over time and invite erosion under the wall. Keep the site well away from overhead power lines, and before any digging or staking starts, call 811, the national call-before-you-dig number, to have underground gas, electric, and water lines marked. Pick a spot that gets good sun, and make sure a proper outdoor power source is within reach for the pump and filter — a long extension cord is not a safe permanent setup.

Check with your local building department before you dig. Many areas require a permit once a pool holds more than a modest volume of water, and nearly all have barrier requirements — a code-height fence, self-latching gate, or approved pool alarm — that apply to above-ground pools too, not just inground ones. It is easier to confirm the rules now than to add a fence after the pool is full. Still deciding which pool and size to buy? See PST's above-ground pool buying guide before you break ground.

Gather materials before the first shovel goes in:

  • A round-point shovel and flat spade for cutting sod and grading
  • A long, straight 2x4 or aluminum screed board
  • A 4-foot level, plus a line level or laser level for checking the perimeter
  • A rubber mallet
  • A wheelbarrow for moving soil and base material
  • Masonry sand, paver base, or a manufactured foam floor pad, plus cove strips if your kit uses them
  • Stakes and string, or a garden hose, to lay out the footprint
  • Work gloves and knee pads
  • Your kit's printed setup guide, read once before you start

Step by step: installing an above-ground pool

The sequence below holds for nearly any above-ground pool, from a 12-foot round to a large oval. Fastener details and track shapes vary by model, so treat this as the roadmap and your kit's setup guide as the specifics.

  1. Lay out and clear the site. Mark the exact footprint with stakes and string or a garden hose, then clear sod, roots, and debris down to bare soil across the marked area plus a couple of extra feet on all sides.
  2. Rough-grade the ground. Check the site with a level and find the high and low points. Cut the high side down to firm, undisturbed soil. Do not touch the low side yet.
  3. Fine-level the entire pad. Work the site in a grid, checking level in multiple directions and at many points, not just a few spots around the edge. The goal is a pad level to within about an inch, end to end.
  4. Lay and screed the base. Spread masonry sand, paver base, or a foam floor pad evenly across the leveled area and screed it flat and firm with a straight board. Set cove strips now if your kit calls for them, where the floor meets the wall.
  5. Assemble the bottom track. Connect the track sections or base plates into the exact shape and size specified for your pool — this locks in the pool's final footprint, so confirm the layout is square before anchoring anything.
  6. Stand and join the wall. Unroll the wall panel into the track and connect the seam with the kit hardware, working evenly around the pool rather than pushing one section up first.
  7. Set the uprights and attach the top rails. Drop each upright into its track slot — resin on a Bay Burst Resin frame, steel on a Bay Burst Hybrid — then connect the top rails and plates that tie the structure together (Bay Burst top rails run 8 inches wide, uprights 7 inches). On an oval, this is also when buttress or strap supports go in along the straight sides; they keep a long wall from bowing under water pressure, so do not skip them.
  8. Install the liner. Drape the liner inside the wall and work it into the bead track or J-hook at the top, moving evenly around in both directions, then smooth it from the center of the floor outward, working out folds by hand before any water goes in. See PST's liner buying guide for overlap, beaded, and unibead styles and mil thickness.
  9. Fill in stages while you smooth wrinkles, then cut in the skimmer and return. Start the water and keep working the liner smooth by hand, or with a soft push broom, as the first few inches go in — wrinkles come out easily now and almost never once the pool is full. Once there is enough water to hold the liner snugly against the wall and the skimmer and return cut-outs sit flat, cut the liner openings and install the faceplates and gaskets.
  10. Finish filling and connect the pump and filter. Fill to the recommended operating level, usually mid-skimmer, then connect the pump and filter, prime the system, and run a full cycle while checking every fitting for leaks. See PST's guide to sizing an above-ground pool pump and filter to match the system to your gallon count.

Leveling: the step that makes or breaks your pool

If this guide only gets one thing across, make it this: leveling is not a step to rush or fake. The entire pad needs to be level to within about an inch, checked in a grid rather than at a few points — a pad can look flat at four corners and still have a low belly in the middle.

There is exactly one correct way to fix an unlevel site: dig the high side down to firm, undisturbed soil. There is a shortcut to never take: building up the low side with loose soil, sand, or fill dirt under the wall or track. Loose fill compacts unevenly under thousands of pounds of water, and a wall that settles unevenly can wrinkle the liner, stress the track seams, or in a worst case, buckle.

Once the grading is right, screed your base layer dead flat and firm, checking level again as you go. The base is not what makes the pool level; the graded ground underneath it is. The base just gives the liner a smooth, cushioned surface to rest on.

Base material What it is Good to know
Masonry sand A thin, screeded layer of sand under the liner Inexpensive and traditional, but unforgiving — it will not hide an uneven pad
Solid patio block or paver base Interlocking paver-base panels or patio blocks under the track and wall line More resistant to washout and burrowing pests than loose sand alone
Manufactured foam floor pad A rolled or interlocking foam underlayment across the whole pool floor Cushions the liner and smooths small surface imperfections; easy to trim to shape

It is also worth remembering that the 35-year manufacturer warranty on a Bay Burst pool assumes the pool went in the way the setup guide describes, so proper grading and leveling are not optional steps to speed through.

Common mistakes to avoid

  • Building on a slope and hoping it settles in. It will settle toward the low side — the exact failure you are trying to avoid.
  • Using loose fill dirt under the track or wall. Any low spot needs to be excavated down to solid ground, never built up with loose material that compresses unevenly under water weight.
  • Leaving wrinkles in the liner. Wrinkles not worked out during the first few inches of filling become permanent, trap dirt and algae, and wear through faster underfoot.
  • Skipping the floor pad and cove. These protect the liner from the base material and from sharp contact where the wall meets the floor, and skipping them raises the odds of an early puncture.
  • Over-tightening the hardware. Bolts and track connectors need to be snug, not cranked down as hard as possible; overtightening can strip fittings or distort the track.
  • Filling too fast to fix wrinkles as you go. Once real weight of water is on the liner, wrinkles are locked in place, and smoothing them out inch by inch beats draining the pool and starting over.

When to hire a professional

Plenty of owners install their own round pool over a weekend with a couple of helpers, but some situations tilt the math toward hiring an installer. Oval pools are more involved than rounds, with buttress or strap supports along the straight runs and a less forgiving track layout, so mistakes cost more. Very large rounds carry more water weight and wall length, raising the stakes on any leveling error. A sloped, rocky, or heavy-clay yard can turn simple grading into a multi-day excavation project. And if you simply do not have a spare weekend or two, a professional crew can finish the same install in far less time. None of this is mandatory — it is just where hiring out tends to pay off. Once the pool is up and running, PST's guide to completing your above-ground pool setup covers everything else it takes to get from a full pool to a swim-ready one.

Frequently Asked Questions

How long does it take to install an above-ground pool?

A straightforward round pool typically takes a weekend for two or three people, from clearing the site through filling the water. Leveling and grading usually take longer than the actual assembly, especially if the yard is not close to flat to start. Larger rounds, ovals, and sites needing real excavation can take several days.

How level does the ground have to be?

The pad should be level to within about an inch across the entire footprint, checked at multiple points in a grid rather than just at the edges. It is the single most important tolerance in the whole project, since liner fit and long-term wall stability both depend on it.

Can I install an above-ground pool on grass?

No. All sod, roots, and organic material need to come out down to bare, stable soil across the whole footprint before grading and leveling begin. Grass and roots decompose over time, which creates uneven settling under the pool long after installation is finished.

Do I need sand under an above-ground pool?

You need some kind of smooth base layer, and masonry sand, paver base, and manufactured foam floor pads are the common options. The base cushions the liner and smooths small surface imperfections, but it does not correct an unlevel site; the ground underneath it has to be properly graded first.

Can one person install it alone?

It is possible on a small round pool, but most steps go faster and more accurately with at least two people, especially standing the wall, setting uprights, and pulling the liner smooth and even in both directions. Grading and leveling a large pad is also much easier with a second set of hands checking level from multiple points at once.
